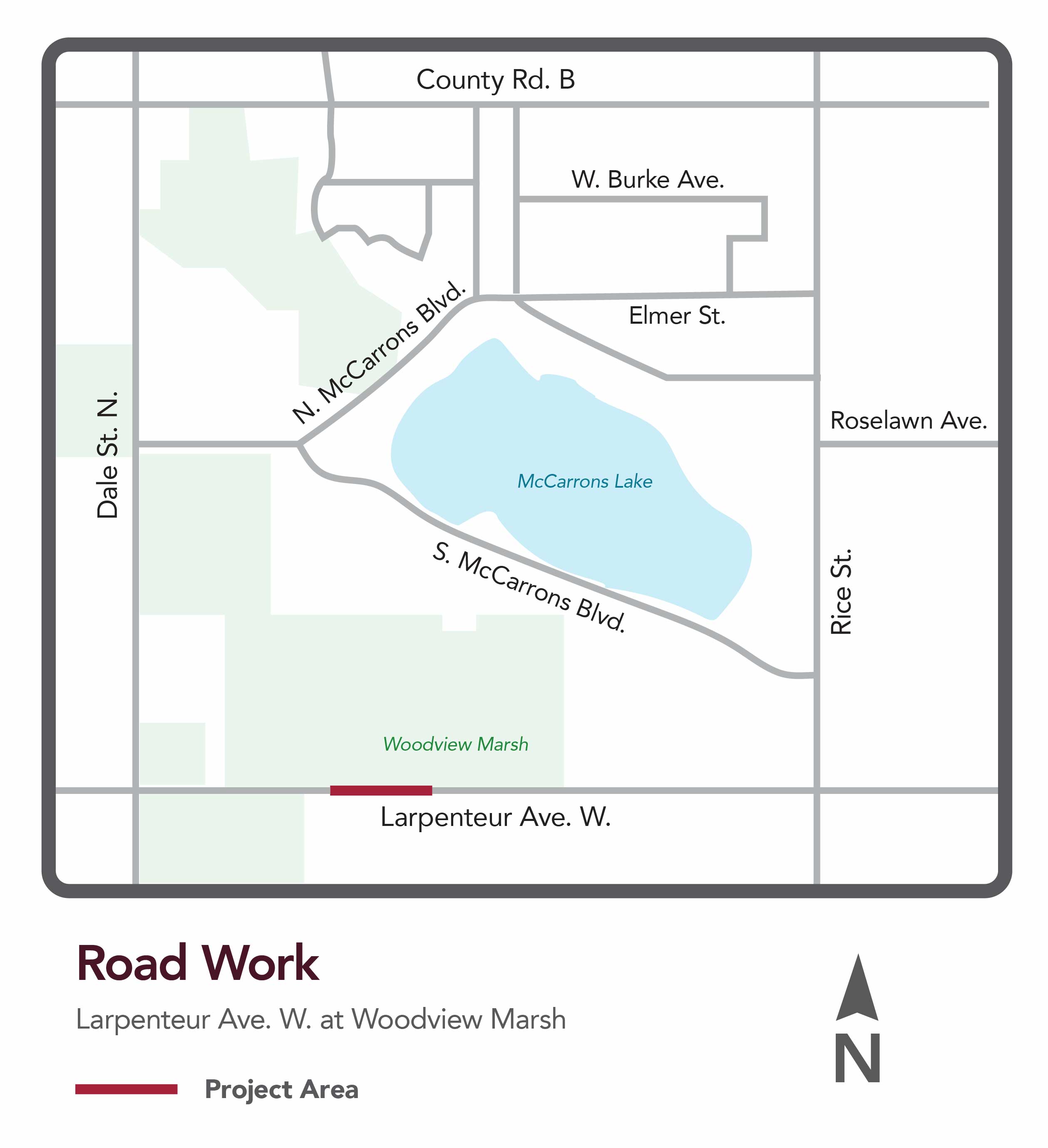

Ramsey County is replacing stormwater pipe and stormwater structures to improve the water quality and protect the area against erosion.
Timeline
- September
- Traffic on the north side of Larpenteur Avenue West is shifted to south side of the road.
- Excavation of the roadway, slope and wetland begins.
- Installation of new storm sewer structures.
- Restoration and paving scheduled for end of September.
- October
- Traffic on the south side of Larpenteur Avenue West is shifted to the north side of the road.
- Excavation of the slope and across the roadway begins.
- Installation of new storm sewer structures.
- Restoration and paving scheduled for mid-October.
Traffic Impacts

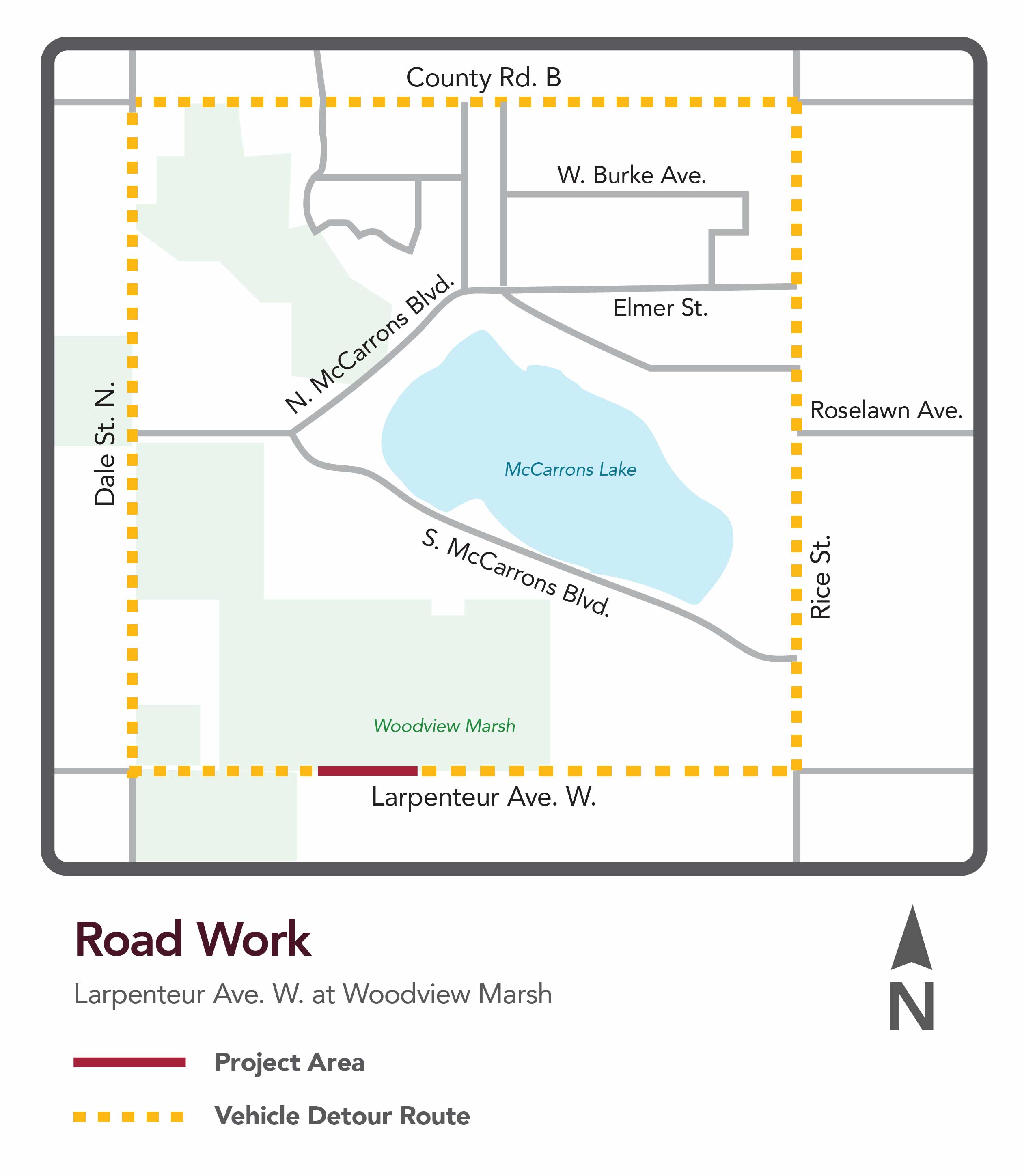

- Vehicle traffic will be one lane in each direction. Please use alternate routes.
- Pedestrians and bicycles follow posted detours.
- Slow down and watch for turning traffic at Mackubin Street and Cumberland Street.
- Expect delays in heavy traffic.
